construction joint for the pool

Undertaking for the Construction Joint for the Pool

Date: xxx

Ref no: CC/DT/DM/14

To,

Dubai Municipality

Building Control section

Dubai, UAE

Project      : 2B + G + 14+ Lower Roof Hotels Building on Plot No. 373-1297 at Barsha, Dubai

Sub             : Undertaking for the construction joint for the pool construction at LB-102 for pool slab and method statement.

Dear Sir,

With reference to the above, we are hereby undertaking that we will follow the method statement at construction joint area being submitted herewith as well as note the following.

Related posts:
Regarding Your Site Inspection Report on 09-07-2017 for Lo (44)1990, Circular (159) 2007, Circular (132)2005, Circular (183) 2011.
Request to Arrange Materials

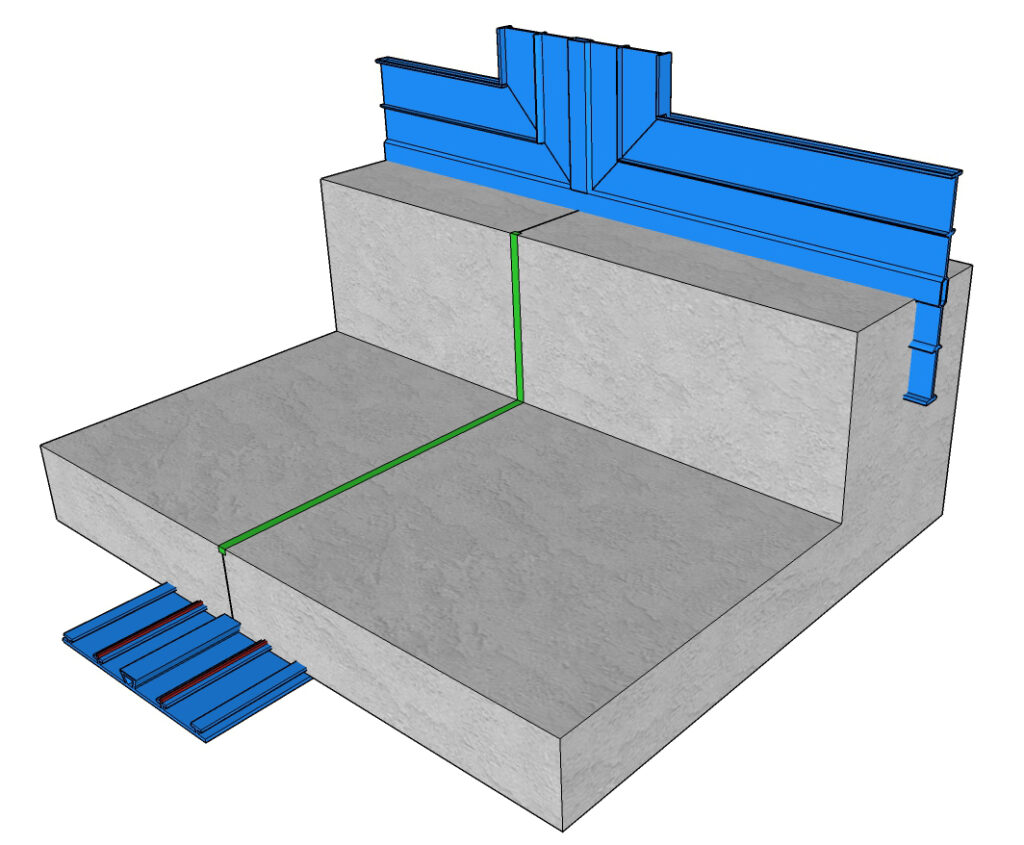

  1.  The DOWELS Placed at LB-1 beam will have additional swelling bar WATER STOPPER/water tight joint to mitigate the cold joint action.
  2. We will also treat the cold joint with non-sinkable mortar prior to apply the pool water proofing.
  3. We will apply bonding agent at cold joint area for the bonding at the construction joint.

So, we will follow the method statement being attached herewith and special preventive measure explained above in item no 1, 2 & 3

This is for your kind review to approve our pool deck area.

Regards,

For xxx Contracting L.L.C

xxx

Project Manager
